BESS Equipment Procurement Guide: The 7-Phase ESS Procurement Process for System Integrators & IPPs (2026)
Table of Contents
- Introduction: Why BESS Equipment Procurement Is Different
- Phase 1: Define Your Procurement Requirements
- Phase 2: Supplier Identification and Shortlisting
- Phase 3: RFP & RFQ Preparation — Get Comparable Quotes
- Phase 4: Supplier Evaluation, Verification & Due Diligence
- Phase 5: Commercial Evaluation — TCO, Not Just Price
- Phase 6: Contract Review — Where Deals Are Won or Lost
- Phase 7: Final Pre-Sign Checklist
- Procurement Strategy, IPPs & Advisory
- Responsible Sourcing and ESG Considerations
- Related Resources
- Frequently Asked Questions
- Summary
BESS Equipment Procurement Guide: The 7-Phase ESS Procurement Process for System Integrators & IPPs (2026)
Last updated: October 2026 | Written by the Enerbe Engineering Team
Introduction: Why BESS Equipment Procurement Is Different
Quick Answer: BESS equipment procurement — also called ESS procurement or battery energy storage procurement — runs through a seven-phase procurement process: (1) define requirements, (2) identify and shortlist suppliers, (3) issue a structured RFP/RFQ, (4) evaluate, verify and run procurement due diligence on each bid, (5) compare total cost of ownership, (6) negotiate the contract, and (7) run a final pre-sign checklist. The selection criteria live in our supplier selection guide and the on-site verification in the factory audit guide; this page is the end-to-end process that ties them together. Expect 8–12 weeks to contract plus 8–16 weeks for production and delivery. The cheapest quote is almost never the cheapest system over ten years.

BESS equipment procurement is not like buying a transformer or a switchgear cabinet. A transformer is a passive component with a datasheet you can verify against a few standards. A BESS is an integrated, software-defined system built from cells, a battery management system (BMS), a power conversion system (PCS), an energy management system (EMS), thermal management and an enclosure. These parts interact, and the way they interact changes over thousands of cycles.
Three things make the equipment procurement process harder than most electrical equipment:
-
Certification sits at system level, not just component level. Cells may carry UN 38.3 and the battery UL 1973, but the complete BESS often needs UL 9540 and UL 9540A for permitting and insurance. Component certificates do not add up to a system certificate.
-
Performance is promised, not visible. Cycle life, capacity retention and round-trip efficiency only reveal themselves over years. You are buying a guarantee about the future, backed by a supplier you hope will still exist to honour it.
-
The decision crosses departments. Engineering, procurement, legal, finance and the insurer all have a say. A process that leaves one of them out tends to stall late, when changes are expensive.
This guide walks through the seven phases in order. For the chemistry and how a BESS works, see our BESS sourcing guide. For sourcing across all LiFePO4 applications, see the B2B sourcing guide.
Phase 1: Define Your Procurement Requirements
Most failed ESS procurements go wrong before a single supplier is contacted. The buyer issues a vague RFQ ("500kWh battery, quote your best price"), gets back five quotes built on five different assumptions, and cannot compare them. Every BESS equipment procurement should begin with a written baseline — every supplier gets the same baseline, and every quote comes back against it.
Technical Requirements
| Parameter | What to Specify | Why It Matters |
|---|---|---|
| Usable capacity | kWh or Ah at the usable DoD window, not nameplate | Nameplate vs usable can differ by 5–10% |
| Power rating | Continuous and peak kW, charge and discharge, with duration | Sets the C-rate and PCS size |
| Duration | Hours at rated power (1h, 2h, 4h) | Defines energy-to-power ratio |
| DC voltage | Nominal and range, e.g. 48V, 51.2V, 600–1500V | Must match PCS and protection devices |
| Cycle life / warranty | Cycles to a stated capacity retention (e.g. 6000 to 70%) | Underpins replacement timing and warranty |
| Operating temperature | Ambient range, with and without HVAC | Drives thermal design and cold-weather limits |
| IP rating | Enclosure ingress protection for the install environment | Outdoor sites need IP54/IP55 or higher |
| Communication | CAN, RS485, Modbus, Ethernet; protocol and data points | Needed for EMS integration and monitoring |
| Round-trip efficiency | Minimum guaranteed RTE at a stated operating point | A few points change revenue over years |
Commercial Requirements
-
Budget and target price per kWh, stated as a range so suppliers can propose options.
-
Required delivery date, including site-ready and commissioning dates, not just ex-works.
-
Installation scope: supply-only, supply and supervise, or full EPC.
-
Warranty expectations: length, performance guarantee, and who services it locally.
-
Payment terms your organization can accept, and any financing need.
-
Spares and training: spare modules, BMS spares, and operator training.
Compliance Requirements
This step identifies which certificates the project needs; how to verify that a supplier actually holds them comes in Phase 4 and in the BESS certification guide.
-
Product and system safety: UL 1973 (battery), UL 9540 and UL 9540A (system), IEC 62619, CE, UN 38.3 for transport.
-
Local codes and grid rules: NFPA 855, local AHJ requirements, and utility interconnection rules.
-
Insurance requirements: many insurers ask for UL 9540A thermal test data before quoting.
Procurement tip: send the draft requirements to engineering, legal and your insurer before the RFQ goes out. If the insurer needs UL 9540A and you only discover that after bids are in, the shortlist collapses and the schedule slips by weeks.
Phase 2: Supplier Identification and Shortlisting
With the requirements fixed, build a long list of candidate suppliers, then cut it to a shortlist of three to five that will receive the RFP/RFQ. Sending it to more than five wastes effort and produces bids you will not evaluate properly; sending to fewer than three removes leverage.
Where to Find BESS Suppliers
| Channel | How to Use It | Watch Out For |
|---|---|---|
| Industry directories | ESA member directory and national storage association lists | Membership is not vetting |
| Trade shows | RE+, Intersolar, ees Europe; meet makers and integrators | Traders exhibit next to real factories |
| Referrals | Ask EPCs, integrators and operators who they have used | One good project is not a track record |
| Online search | Find suppliers, then verify; do not shortlist on search rank | SEO favours resellers over makers |
| Industry reports | BNEF and Wood Mackenzie supplier and tier listings | Tier status covers cells, not the full BESS |
| Certification databases | UL Product iQ and TÜV online directories | Confirms certificates exist before you invest time |
Cutting to the Shortlist — and BESS Integrator Assessment
Screen the long list against fixed criteria and keep the three to five suppliers that pass. The criteria, how to verify each one, and a supplier qualification form are in the supplier selection guide. Look for similar-size reference projects, current model-specific certificates, an owned factory rather than a trading office, stable finances, verifiable references, traceable Grade A cells and in-house engineering with a local service route.
If you are buying a turnkey system from an integrator rather than directly from a battery factory, the BESS integrator assessment uses the same seven criteria plus integration-specific checks: whose cells and BMS they use, who holds the system-level UL 9540 certificate, their completed projects of similar size and duty, the EMS and commissioning capability, and where warranty responsibility sits across battery, PCS and EMS. Visit reference sites and, where possible, the factory of the battery manufacturer behind the integrator — an integrator's quality cannot exceed its supply chain.
Phase 3: RFP & RFQ Preparation — Get Comparable Quotes
The RFQ's job is to make quotes comparable. If five suppliers each decide their own scope, Incoterms and what to include, the "cheapest" quote may simply be the one that left out the most. A good RFP or RFQ fixes scope and format so price differences reflect real differences.
RFP vs RFQ: Which One to Issue
An RFQ (Request for Quote) is used when you already have a fixed technical specification and want comparable prices on a common scope. An RFP (Request for Proposal) is used earlier, when the solution is still open and you want suppliers to propose the configuration, capacity and architecture. Many BESS equipment procurements begin with an RFP to shortlist approaches, then convert to a detailed RFQ for the finalists. Either way, use one scope and format so the responses are comparable.
What the RFP/RFQ Should Contain
-
Project overview: location, application, site conditions, grid connection point, commissioning date, and the duty cycle the system will see.
-
Requirements baseline: attach the technical, commercial and compliance requirements from Phase 1 rather than retyping them; ask suppliers to confirm each line or take a written exception.
-
A common quote format: fixed Incoterms and place, one currency, a clear scope boundary, and a line for what is included and excluded (PCS, EMS, transformer, HVAC, fire suppression, cabling, commissioning, spares). State how long the price must stay valid.
-
Supplier information request: company background and ownership, factory location and size, production lines and monthly output, cell brand and source, ISO 9001/14001/45001, reference projects with contacts, and latest audited financials or a bank reference.
-
Process and dates: submission deadline, the address or portal for bids, the basis on which quotes will be evaluated, and the expected audit and award dates.
Common RFQ mistake — Incoterms: asking some suppliers to quote DDP and others FOB makes prices impossible to compare, and DDP from an overseas maker can hide duties, clearance risk and an unclear transfer of liability. Fix one Incoterm (commonly CIF or FOB for port delivery, with you handling destination clearance) and ask every supplier to use it. Confirm the freight forwarder accepts LiFePO4 under UN 3480/UN 3481 before the order is placed; see the shipping certifications guide.
Phase 4: Supplier Evaluation, Verification & Due Diligence
Once bids come back, evaluate them in three stages. The point of this phase is to confirm that what a supplier promised on paper is true, using the same standard for every bidder. This is the procurement due diligence step of the process; the detailed criteria, weights and scoring matrix are in the selection guide.
| Stage | What You Do | Reference |
|---|---|---|

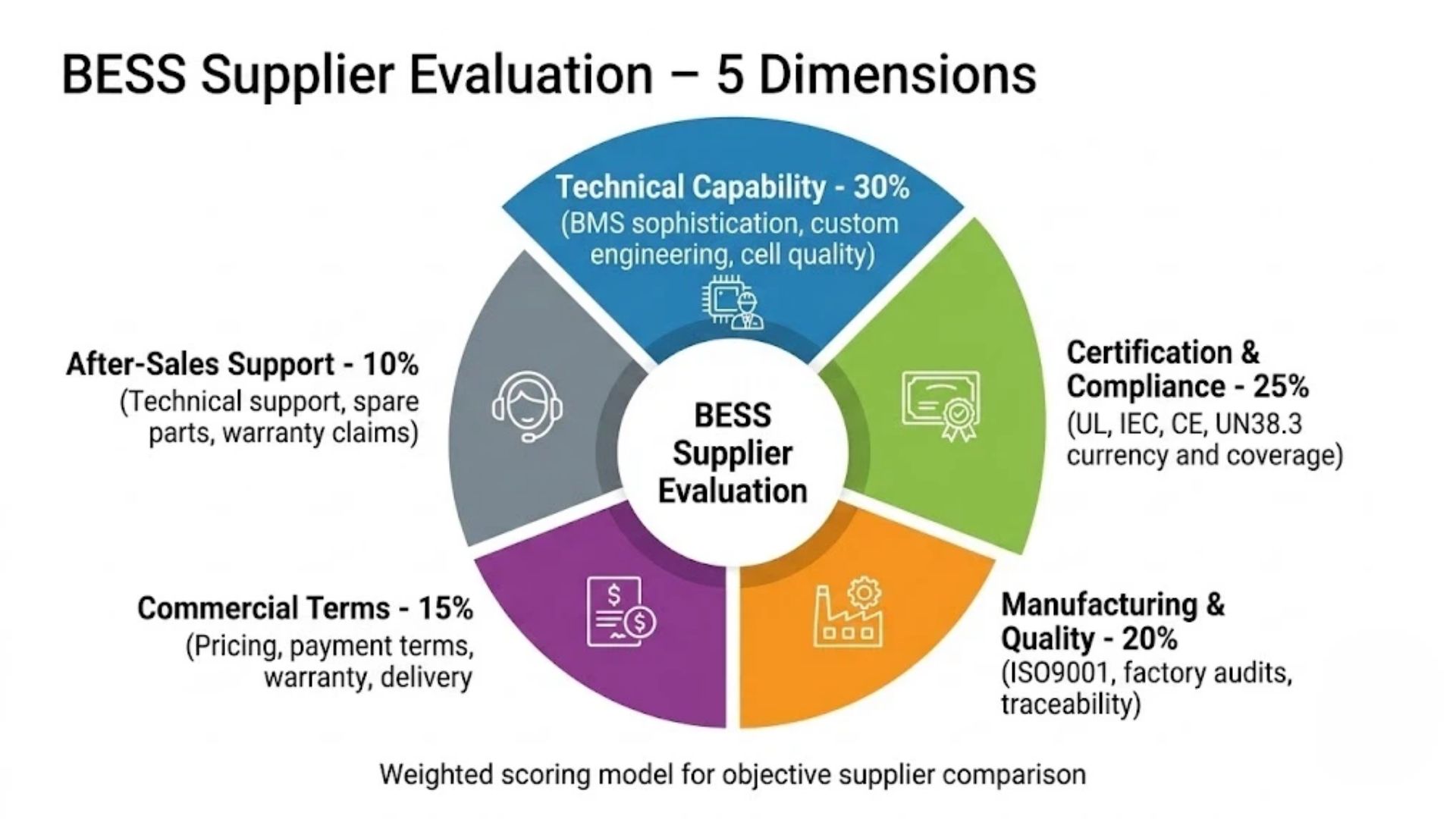

| 1. Paper scoring | Score every quote against the same weighted table covering technical fit, certification, manufacturing, commercial terms and after-sales; record scores and reasons in writing. | Selection & scoring guide |
| 2. Verification & due diligence | Check each certificate against the issuing body's online database, confirm manufacturing capability on site, by live video or through a third party, and call the reference projects. | Factory audit guide & certification guide |
| 3. Sample / first batch | Test a sample or the first batch for BMS configuration, Hi-Pot, capacity, aging and communication, and keep a pre-shipment inspection on later batches. | Audit guide (end-of-line tests) |
Key point: keep upfront price to roughly 30% or less of the evaluation weight. When price dominates, every other criterion becomes decoration, and the bid with the thinnest scope and weakest BMS wins for reasons that show up in year two. Written scores also protect you if an unsuccessful bidder challenges the award.
Phase 5: Commercial Evaluation — TCO, Not Just Price
After the technical and verification stages, compare the surviving bids on total cost of ownership across the project life. TCO adds the costs that a purchase price ignores.

| Cost Component | What It Includes |
|---|---|
| Upfront capital | Battery, PCS, EMS, enclosure, balance of system, installation, commissioning |
| Operating cost | HVAC and parasitic load, driven partly by round-trip efficiency |
| Maintenance | Planned service, filters, inspections, and service contracts |
| Replacement | Module or pack replacement when capacity falls below the guarantee |
| Financing | Interest and fees over the repayment period |
| Downtime | Lost revenue or penalties during failures and repairs |
| Risk and end of life | Warranty default risk, decommissioning, transport and recycling |
Quotes often use different capacity bases and warranty lengths. Normalize them to a common unit, typically cost per usable kWh and cost per warranted cycle or year, before ranking. In a typical comparison the lowest-priced quote can be the most expensive per usable kWh; once unit prices tie, warranty, efficiency and the verification results decide it. A system at 95% RTE returns 5% more stored energy than one at 90% on every cycle, and that difference compounds into measurable revenue over ten years.
Phase 6: Contract Review — Where Deals Are Won or Lost
The contract turns sales promises into enforceable terms. Have legal review it, and do not sign a document that simply attaches the supplier's standard quotation.
Warranty Terms
-
Two separate guarantees: a defect warranty (years) and a performance/capacity guarantee (minimum capacity at a stated number of cycles or years). Do not accept one vague phrase covering both.
-
Defined capacity test: the method, temperature, rate and instrument used to measure capacity when a claim is made.
-
Remedy: repair, replacement or refund, who pays transport and installation, and the time limit.
-
Exclusions: read them; improper installation, temperature abuse and "failure to follow the manual" can void broad parts of the cover.
-
Local servicing: who performs warranty work in the country of installation and how they are trained.
-
Supplier survival: what happens if the manufacturer is acquired or ceases trading; a parent-company guarantee or warranty bond helps on large orders.
Delivery and Acceptance Terms
-
Delivery dates and Incoterms, with a defined transfer of risk and the freight forwarder's acceptance confirmed.
-
Late-delivery penalties (liquidated damages), usually a percentage of contract value per week, capped.
-
Acceptance and testing: factory acceptance test (FAT), site acceptance test (SAT), and pass criteria before title or final payment.
-
Packaging and documentation: packing list, commercial invoice, MSDS, UN 38.3, test reports, manuals and certificates.
-
Spare parts: agreed quantities, prices and availability period.
-
Training and commissioning support: scope, dates, and who covers travel costs.
Payment Terms
-
A common pattern is 30% deposit, 60% before or against shipment, 10% retained after successful SAT.
-
Avoid large upfront payments to suppliers you have not worked with; they transfer all delivery risk to you.
-
Use letters of credit for high-value first orders, with payment triggered by agreed shipping documents.
-
Retention: hold 5–10% for 60–90 days after commissioning so defects found on startup are fixed before the account is closed.
The clause that matters most: acceptance testing plus a retention payment. Without an FAT/SAT pass criterion you cannot reject a defective system on arrival; without retained money you have little leverage once the supplier is paid in full. Together they are the cheapest insurance in the contract.
Phase 7: Final Pre-Sign Checklist
Before signing, walk through this list with the file in front of you. It confirms the earlier phases are complete rather than relying on memory.
-
The proposal matches the Phase 1 baseline: scope, model, configuration, and every line is accepted or has a written exception.
-
Paper scoring is complete and filed for every bidder, with reasons recorded.
-
Certificates are current, model-specific, and include the system-level certificates the project needs; verification is documented.
-
Factory verification is complete, on site or remote, and reference projects were contacted.
-
TCO was compared for the finalists on the same capacity and warranty basis.
-
The contract defines both warranties, the capacity test, the remedy, and local servicing.
-
FAT/SAT acceptance criteria, late-delivery penalties, payment schedule and retention are agreed.
-
Insurance cover is confirmed in writing, including any UL 9540A condition.
-
Deliverables, documentation, spare parts and training are listed in the contract.
-
Freight forwarder acceptance under UN 3480/UN 3481 is confirmed before production completes.
Procurement Strategy, IPPs & Advisory
Framework agreements for multi-project developers
Developers and EPCs that run several projects a year should not start from scratch each time. Turn procurement into a repeatable process:
-
Pre-qualify two to three suppliers through the selection and audit process once, then refresh the qualification annually.
-
Negotiate framework agreements with volume pricing, fixed lead times and pre-agreed warranty terms that each project calls off.
-
Standardize on one or two configurations across projects to cut engineering, spares and training cost.
-
Build a certification library with current certificates and test reports so each project's permit pack is assembled in days.
-
Establish third-party inspection relationships in advance with a standing pre-shipment scope.
-
Track supplier performance with scorecards: on-time delivery, defects, warranty response and efficiency.
BESS procurement advisory for IPPs and first-time buyers
Independent power producers (IPPs) and first-time developers often lack an in-house battery engineering or procurement team. BESS procurement advisory — typically from an owner's engineer or independent technical advisor — covers market screening, writing the technical specification, running the RFP/RFQ, bid evaluation and independent factory verification. It keeps the process impartial and closes the scope and certification gaps that inexperienced teams miss, and is usually a fixed-fee or milestone engagement that costs far less than a single under-specified purchase.
Responsible Sourcing and ESG Considerations
Responsible sourcing used to be an ESG checkbox. It is becoming a regulatory condition for selling batteries, especially into the EU, and a requirement from corporate and utility buyers with their own net-zero commitments. The EU Battery Regulation (2023/1542) introduces, in phases, supply-chain due diligence, a battery passport, recycled-content minimums for cobalt, lithium, nickel and lead, carbon-footprint declarations, and collection and take-back obligations.
What Responsible Sourcing Covers
-
Ethical extraction of lithium, cobalt, nickel, manganese and graphite, without child or forced labour.
-
Supply-chain due diligence aligned with OECD guidance, with documented risk assessment and mitigation.
-
Recycled content in cells and a route to verify the claimed percentage.
-
Carbon footprint of the battery, from raw materials through manufacture.
-
Collection, take-back and recycling arrangements at end of life.
-
A battery passport or equivalent digital record carrying materials, performance and due-diligence data.
Questions to Ask in the RFQ
-
Do you operate a supply-chain due-diligence policy aligned with OECD guidelines, and may we see it?
-
Which materials carry third-party responsible-sourcing certification or audit, and who issued it?
-
What recycled content can you offer, and how is it verified?
-
Can you provide a carbon-footprint declaration for the battery model?
-
How will you support the battery passport and what data will you supply?
-
What take-back and recycling commitments apply in the destination market?
For projects bidding into public tenders or supplying large corporate offtakers, weak answers here can disqualify a bid even when the technical and commercial terms are strong. Ask early, in the RFQ, so it is part of the evaluation rather than a last-minute scramble.
Related Resources
-
How to Choose a BESS Supplier: 7 Key Criteria — selection criteria, supplier qualification and the weighted scoring table.
-
BESS Factory Audit Guide — on-site and remote verification, the floor walk and reliable vs risky evidence.
-
BESS Certification Guide — UL 1973, UL 9540/9540A, IEC, CE and UN 38.3.
-
BESS Sourcing Guide — how a battery energy storage system works and where it is used.
-
LiFePO4 Battery Shipping Certifications — UN 3480/UN 3481 and freight forwarder requirements.
-
48V Rack-Mounted LiFePO4 Battery Guide — rack modules and project-buyer specs.
-
LiFePO4 Battery Lifespan Guide — cycle life and degradation.
Frequently Asked Questions
Q1: What is the most critical step in BESS procurement?
Defining requirements and confirming the system-level certification before you compare prices. If the project needs UL 9540 and UL 9540A for the permit and insurance and a supplier only holds component-level certificates, no price advantage fixes that. Write the requirements baseline in Phase 1, then verify certificates against the issuing-body database in Phase 4.
Q2: Should I choose the lowest-priced BESS supplier?
Not when the low price comes with higher risk or thinner scope. Normalize quotes to cost per usable kWh, then compare total cost of ownership. A supplier with a slightly higher price but longer cycle life, higher efficiency, verified certificates and an enforceable warranty often costs less over ten years.
Q3: How long does BESS procurement typically take?
A typical ESS procurement process takes 8–12 weeks from requirements baseline to contract: 1–2 weeks to define, 2–3 weeks to identify and shortlist, 1–2 weeks for the RFP/RFQ and quotes, 2–4 weeks for evaluation and audits, and 1–2 weeks for TCO and negotiation. Production and delivery add another 8–16 weeks; permit and grid timelines often run longer, so start them in parallel.
Q4: What is BESS equipment procurement, and how is it different from standard procurement?
BESS equipment procurement sources the storage system as an integrated system rather than as separate parts. The key difference is system-level certification and responsibility: the battery, PCS, EMS, enclosure and thermal/fire systems must work together and, for many markets, carry UL 9540 as a complete system with UL 9540A thermal data. Buying certified components separately and assembling them does not produce a certified system and leaves the integration risk with you. Define in the RFQ whether the supplier delivers the certified, commissioned system or components only.
Q5: What red flags should I watch for in BESS supplier proposals?
Pending or expired certificates, certificates not specific to the quoted model, reluctance to share test reports or the cell source, no verifiable references, refusal of a factory visit or live video, a price far below every other bid with no explanation, and pressure to pay a large deposit quickly. A supplier that becomes defensive when asked to verify a claim is itself a sign.
Q6: Do I need a third-party inspection before BESS shipment?
For commercial and utility-scale projects, yes, at least on the first order. A pre-shipment inspection checks configuration, quantity, workmanship, BMS settings, safety tests and documentation against the PO, and typically costs $500–$1,500 — far less than returning or replacing a container of modules. On later call-offs under a framework agreement, buyers often reduce inspection to sampling.
Q7: What is BESS responsible sourcing, and why does it matter?
It means confirming battery materials are extracted and processed under acceptable environmental, labour and human-rights conditions, with due diligence, recycled content, carbon and take-back commitments, and the data a battery passport requires. The EU Battery Regulation makes parts of it a legal condition for sale, and public tenders and large corporate buyers increasingly require documented evidence.
Q8: How do I develop a BESS procurement strategy for multiple projects?
Pre-qualify two or three suppliers through selection and audit, sign framework agreements with volume pricing and fixed lead times, standardize on one or two configurations, keep a current certification library, set up standing third-party inspections and score suppliers after every delivery. This turns repeated one-off negotiations into a call-off process and cuts both lead time and risk.
Q9: What is the difference between an RFP and an RFQ in BESS procurement?
An RFQ (Request for Quote) is used when you already have a fixed technical specification and want comparable prices on a common scope. An RFP (Request for Proposal) is used earlier, when the solution is open and you want suppliers to propose the configuration, capacity and architecture. Many BESS equipment procurements start with an RFP to shortlist approaches, then issue a detailed RFQ to the finalists.
Q10: What is BESS procurement advisory, and do IPPs need it?
Procurement advisory, usually from an owner's engineer or independent technical advisor, supports IPPs, EPCs and first-time buyers through market screening, writing the technical specification, running the RFP/RFQ, bid evaluation and independent factory verification. IPPs without an in-house procurement or battery engineering team use it to close scope and certification gaps and keep the process impartial. It is usually a fixed-fee or milestone engagement that costs far less than a single under-specified purchase.
Q11: How do I assess a BESS integrator rather than a battery factory?
If you buy a turnkey system from an integrator, assess the same seven criteria plus integration-specific points: whose cells and BMS they use, who holds the system-level UL 9540 certificate, their completed projects of similar size and duty, the EMS and commissioning capability, and where warranty and service responsibility sit across battery, PCS and EMS. Visit reference sites and, where possible, the factory of the battery manufacturer behind the integrator.
Summary
The BESS equipment procurement process works as seven phases. Run them in order and keep the criteria, the verification and the paperwork consistent across every bidder.
-
Define requirements first and give every supplier the same technical, commercial and compliance baseline.
-
Shortlist three to five suppliers using fixed screening criteria, then issue one RFP/RFQ with a common scope and quote format.
-
Evaluate in three stages: paper scoring, certificate and factory verification/due diligence, and a sample or first-batch check.
-

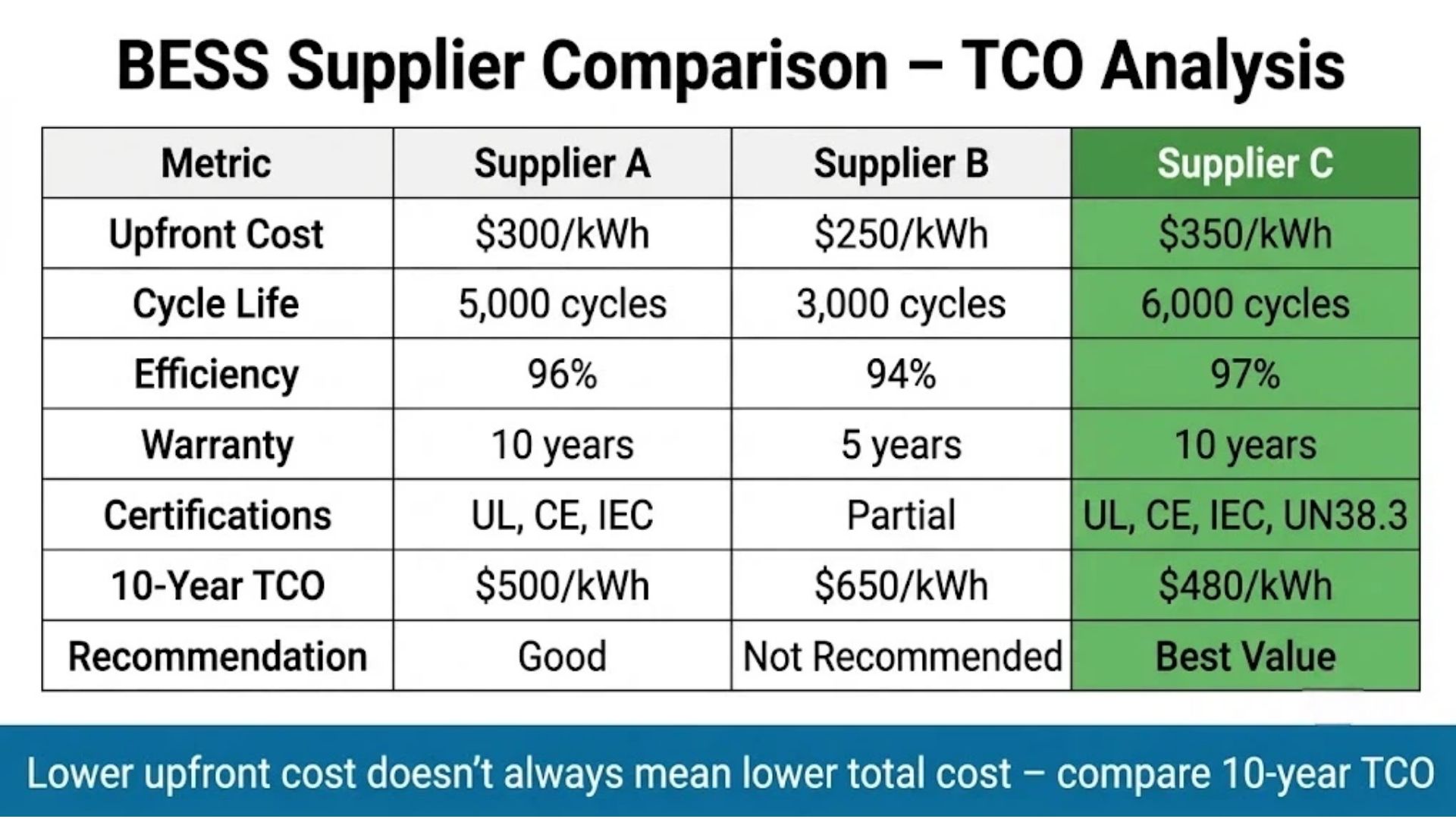

Compare TCO, not price, normalized to cost per usable kWh; the cheapest quote is rarely the cheapest system.
-
Put acceptance testing and a retention payment in the contract, alongside clear warranty, delivery and payment terms.
-
For repeat projects, pre-qualify suppliers and use framework agreements; IPPs can bring in procurement advisory for impartial support.
-
Treat responsible sourcing as a requirement, not an option, where the EU Battery Regulation or corporate buyers apply.
The most common expensive mistake is awarding on upfront price after comparing quotes that were never built on the same basis. A structured procurement process costs a few extra weeks at the start and prevents failures, disputes and replacements that cost far more later.
Enerbe supplies LiFePO4 battery systems for commercial, industrial and utility-scale storage, with UL 1973, UL 9540, IEC 62619, CE and UN 38.3 documentation, and supports integrators and EPCs with technical packs, certificate verification, factory audits and commissioning support. For wholesale pricing or a custom configuration, contact our engineering team or view the products.
The procurement analysis in this article is the independent view of Enerbe, based on 15+ years of battery manufacturing and B2B supply experience.
Get In Touch
Ready to source LiFePO4 batteries for your project? Contact Enerbe today.

📄 Request a Technical Datasheet
Contact Us →📞 Speak with Our Engineering Team
Get In Touch →🔗 Browse Our Custom Battery Solutions
View Products →Dongguan A&S Power Technology Co., Limited.
Building 1, No. 2, Keji 9th Road,
Songshan Lake, Dongguan, Guangdong, China
📞 +86 137 1383 1631
✉ info@aspowerbattery.com
Stay Charged. Stay Connected.
BESS Sourcing & Procurement Guide: The Complete Battery Energy Storage System Overview for B2B Buyers (2026)
How to Qualify & Audit a Reliable BESS Supplier: Prequalification, Capability Assessment, Factory Audit & Approval Workflow (2026)
